Category: Business CentralRead time: 6 MinsPublished on: 14 Nov 2025

How to Avoid Production Delays in Business Central Due to Missing Components

Key Takeaways:
  • In Microsoft Dynamics 365 Business Central, missing components can silently disrupt production. The system does not alert users about shortages until the posting stage, leading to avoidable downtime.
  • With a proactive restriction, you can check component availability during BOM refresh, get alerts on shortages, and automatically create linked replenishment orders.
  • This ensures production starts only when materials are ready.

Every production team knows this moment when a work order seems ready, but a single missing part brings everything to a halt. Your machines sit idle. Your delivery schedules slip. Your customers wait for updates. A single missing component can throw off your master production schedule, making on-time delivery impossible.

In most cases, these problems start inside the ERP itself. In Microsoft Dynamics 365 Business Central, users can create and refresh production orders even when materials are short. The system does not issue a warning until the posting stage. By then, it is too late.

Our Business Central consultants have seen how this gap quietly drains efficiency. With a simple, proactive control, an enhancement that helps you stops production before it starts when components are not available.

1. Limitation in Business Central to Prevent Production Delays Due to Component Unavailability

In standard Microsoft Dynamics 365 Business Central, the production module does not validate material availability when creating or refreshing a production order. The system loads all components into the order, regardless of current stock levels.

Business Central is a strong production platform, but its default behaviour leaves one key risk unchecked.

  • There is no early warning when a user creates or refreshes a production order.
  • Shortages only appear during Production Journal posting.
  • No automatic replenishment is triggered, and planners must create orders manually.

A sample screenshot of a business application displaying a pop-up over an order management screen in Business Central.

This reactive flow causes downtime, missed deadlines, and strained customer relationships. For manufacturers running tight schedules, this is a serious operational cost.

2. Why Manufacturers Need a Proactive Control

Modern manufacturing depends on timing. Even small delays disrupt entire production lines. That is why your system should prevent users from starting production without all the required components.

Restricting users early does more than stop errors:

  • It prevents unplanned halts on the shop floor.
  • It protects delivery timelines and customer commitments.
  • It supports just-in-time reliability, ensuring every order starts on solid ground.

Restricting users ensures production starts only when all required components are secured or replenishment is in motion. This proactive safeguard shifts Business Central from reactive issue handling to controlled and predictable production planning.

By introducing early restriction, manufacturers can align production orders with both material and capacity planning, ensuring that production schedules reflect not just available components, but also resource availability.

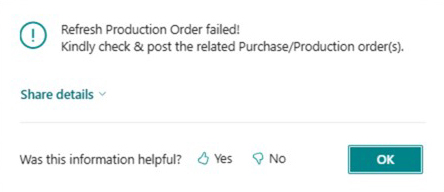

A sample screenshot of a production order error message box from Business Central application.

3. Intelligent Component Availability Check in Business Central

Customize your Microsoft Dynamics 365 Business Central system with an intelligent component availability check during the Bill of Materials (BOM) refresh process.

This complements the platform’s material requirements planning (MRP), giving production planners a full picture of what is needed, when it is needed, and before any job proceeds. It transforms production control from reactive to preventive by validating materials before execution begins.

When a user refreshes a Bill of Materials (BOM) in a production order, the system automatically checks each component’s availability in real time.

If even one part is short, the refresh is stopped. The user gets an alert showing which components are missing and the current inventory levels for each item. From there, the user can choose to:

  • Create purchase or sub-production orders automatically.
  • Review shortage quantities and expected due dates before resuming.

Production can only continue once all required materials are available or replenishment orders are confirmed.

This proactive control eliminates wasted setup time, prevents mid-process stoppages, and ensures that every production order in Business Central begins with full material readiness.

4. How Work Order Restriction Prevent Production Delays in Business Central

Whether your manufacturing operation is high-volume or highly customized, this restriction mechanism integrates directly into the Business Central production workflow. The restriction mechanism integrates directly into the standard Business Central production workflow. It runs automatically during the component refresh process, ensuring production cannot proceed without confirmed component availability.

  • When a business user plans to manufacture a product for a particular location on a certain date, the user will create a production order in Business Central.
  • During the refreshing of components, the system will prompt an indication if you don’t have sufficient components to meet the production demand.
  • On the given date, the raw components availability is calculated based on the Inbound and outbound transactions (open sales orders, purchase orders, and any other work orders that are consuming the same raw material).
  • In BC, there is an existing logic, which calculates “Item available to promise”, which is utilized to effectively calculate the item’s availability.
  • A work order component contains raw materials and/or semi-finished goods.
  • If your raw materials are not available, a purchase order will be placed.

Note: If your component item has a vendor number assigned in the item master, a Purchase Order will be created. Otherwise, you will see an error prompting you to add the vendor number for that item.

  • If your semi-finished goods are not available, a planned production order will be created.
  • Your related orders (Purchase/ Production order) have a corresponding Production order number populated in the Work Description for audit identification.
  • The work order will not be refreshed until the respective orders are posted, unless any manual orders are created that will ensure the item’s availability.

This automated sequence ensures every production order in Business Central starts with full component readiness, which reduces downtime, prevents manual oversight, and maintains schedule reliability.

Work Order Creation Process

Purchase order / Planned production order for the specific item is automatically created. To utilise the partial availability of inventory (if exists), the quantity is recorded as

Order Quantity = Quantity Needed – Available Quantity

Due Date of raw component based on the Lead time and Production order (FG) Starting date.

Note: As mentioned above, available quantity is calculated based on the Item’s available to promise logic for the required date.

Limitations to Work Order Restriction Enhancement in Business Central

Your unlinked orders were left abandoned. Though those orders have work descriptions populated with the Production Order number, they are not deleted due to certain functional and technical blockers.

5. Handling Linked and Unlinked Orders

The custom restriction logic in Business Central adds transparency and traceability to every replenishment process. Each automatically generated purchase or sub-production order is linked directly to the parent production order.

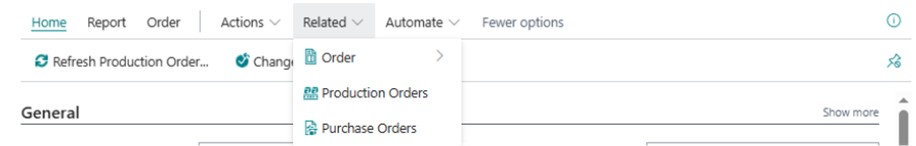

A sample screenshot of Business Central application's menu bar showing multiple options for order production orders, and purchase orders.

Design a provision for the users to navigate to the related Purchase order / Planned productions orders. List it udner Planned Production Order & Released Production Order pages.

There are cases that unlink the related orders. Any inbound orders that satisfy the inventory need and when the user try to refresh the work order. At this stage, the link between the orders (which you should create) and the current work order is removed.

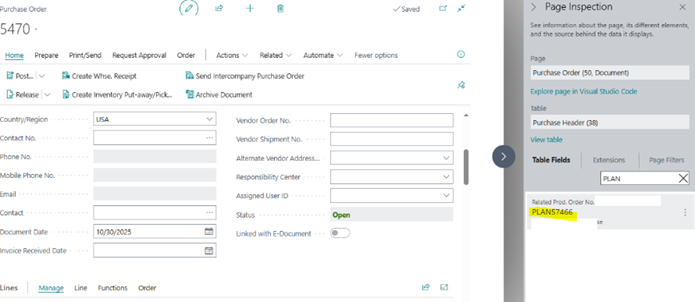

A sample screenshot of Business Central application displaying a Purchase Order form and a Page Inspection sidebar.

6. Key Benefits of Restricting Users to Avoid Production Delays in Business Central

Implementing a proactive restriction mechanism in Business Central delivers measurable operational and planning benefits. Each production cycle becomes more predictable, traceable, and aligned with material readiness.

  • Prevent last-minute halts – eliminate mid-production surprises.
  • Boost planner efficiency – proactive alerts reduce manual checks.
  • Ensure on-time deliveries – protect customer schedules.
  • Improve supply chain responsiveness – automatic replenishment triggers quicker recovery.
  • Maintain full traceability – linked orders form a clear audit trail.
  • Fit for all industries – applicable to any manufacturer using production orders.

This restriction approach transforms Business Central from a reactive control environment into a proactive production management system that minimizes risk and maximizes schedule accuracy.

7. Restricting Work Order Due To Component Unavailability Ensures Efficiency

Manufacturers do not need to wait for a posting error to know something is missing.

With restriction logic, Business Central can now ensure that production starts only when all components are confirmed and ready. This not only improves production execution but also elevates your entire supply chain management by reducing unexpected shortages and expediting procurement when necessary.

Ready to eliminate component-related production delays? Contact our Business Central experts today to see this proactive control in action and keep every production order fully prepared before it starts.
